Malahat Beach Restoration

Malahat Beach Restoration

Started: April 1, 2023
Target: December 31, 2025

Overview

Malahat oral history describes màlexelh (or Village Point) as the location of the historic Malahat village, when the land stretched much further out and longhouses lined the beach. It was a site that was intensely used and occupied by the Malahat people on a permanent basis. The site is highly significant in cultural, historical, and archaeological terms. The site is currently a gathering place for community, home to the Malahat canoe shed and canoe races, and is the main access point to the water for the community. This important site has unfortunately been subject to significant erosion due to wave and ferry wake action, resulting in a dramatic loss of land and the exposure and loss of cultural materials. The site was in a vulnerable state, with visible sloughing and worsening of the erosion after king tides and winter storms.

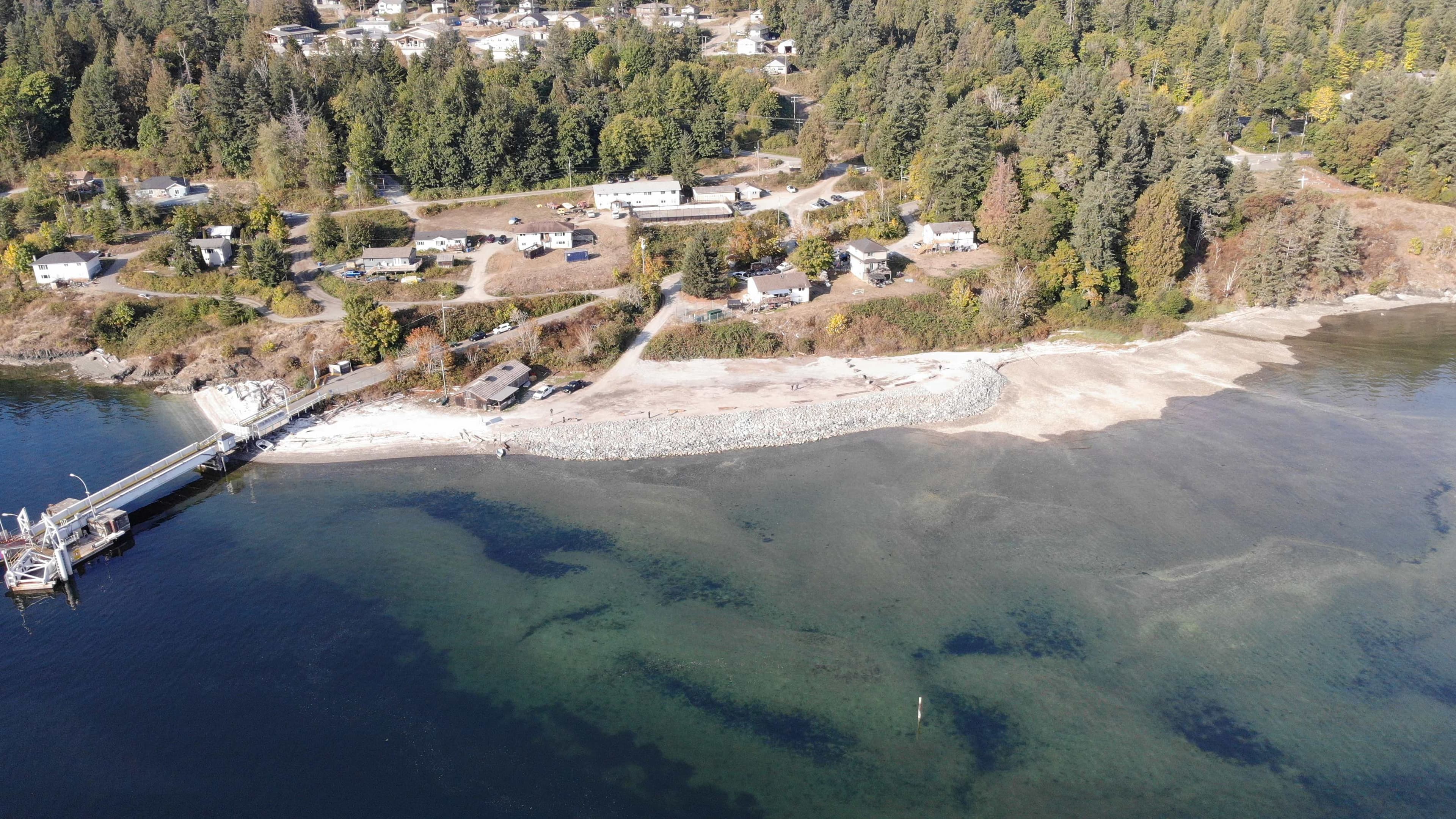

The Phase I of this project involved the immediate protection of the eroding bluff by placing a riprap revetment along the shoreline at the high water mark. This was an emergency measure to halt erosion and is being followed by beach restoration, landscaping, and the creation a of a community gathering space that recognizes the history and ongoing importance of the beach, from canoeing and clamming to ceremony and language.

Phase II (ongoing) will create a new beach area, address flooding behind the riprap wall, and provide a starting point for revitalizing the communal space while protecting clam beds and community infrastructure.

Project Contacts

Linus Shaw

Stewardship Coordinator

Project Timeline

  • Phase I: Riprap Installation/Erosion Proctection

    Completed

    Apr 2023 - Oct 2023

    This phase of the project was completed in Summer 2023 by Malahat Nation and Copcan Civil Construction.

    A large riprap (rock) wall was placed over the eroding bluff. The rocks were buried over a metre deep on the seaward side, and a geotextile blanket was placed over the bluff and under the rocks to ensure no material is further lost to erosion.

    This immediately protected the village site, homes, and the backshore area but the area still faces flooding during storms and winter king tides.

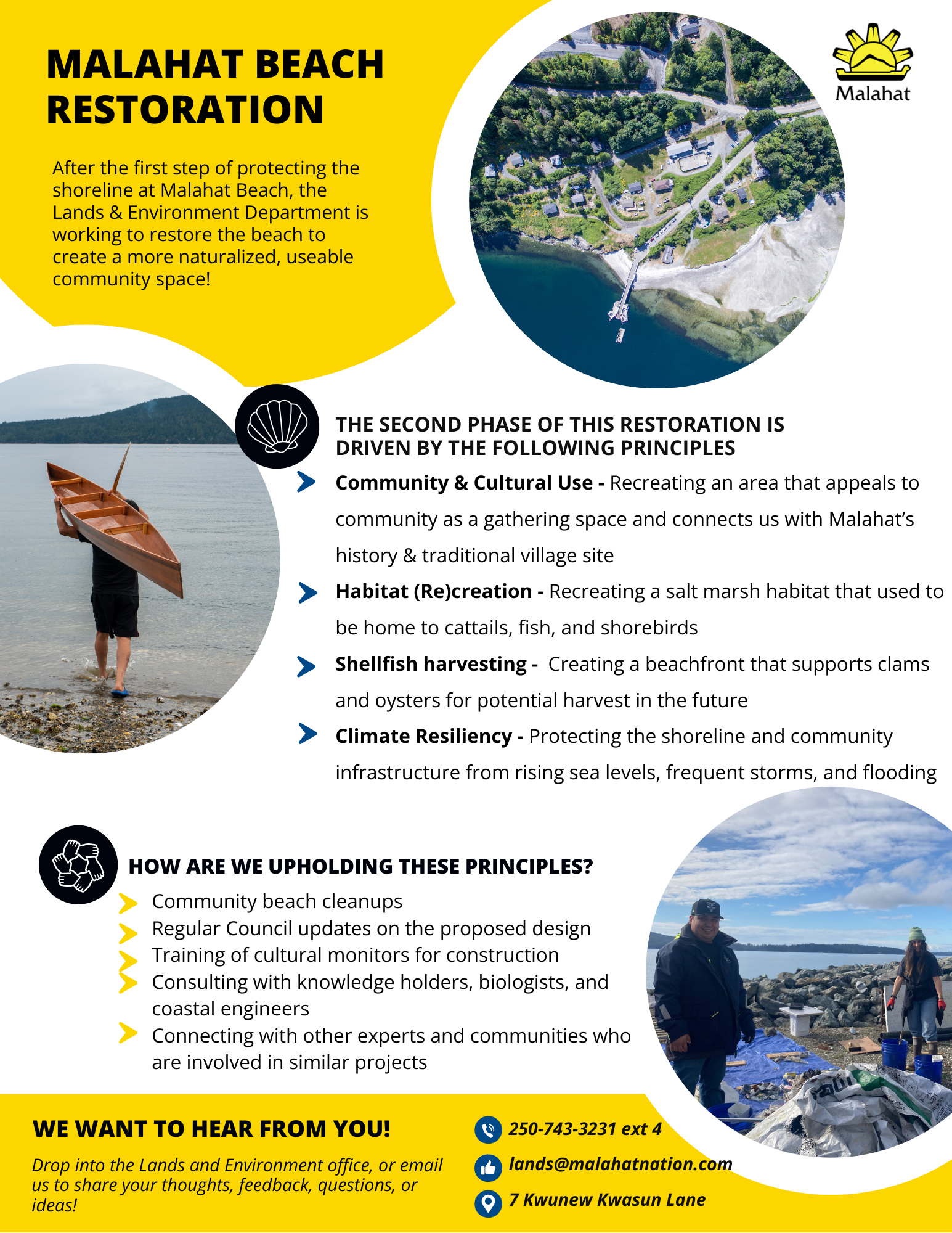

  • Phase II: Design

    Completed

    Jan 2024 - Jul 2025

    Malahat Lands & Environment is working with Chief & Council, community members, engineers from Kerr Wood Leidal, and biologists from Archipelago Marine Research to design a new beach that addresses the many uses of Malahat Beach, including:

    • Flood protection
    • Clam harvesting
    • Recreation & community space
    • Shorebird and saltwater marsh habitat

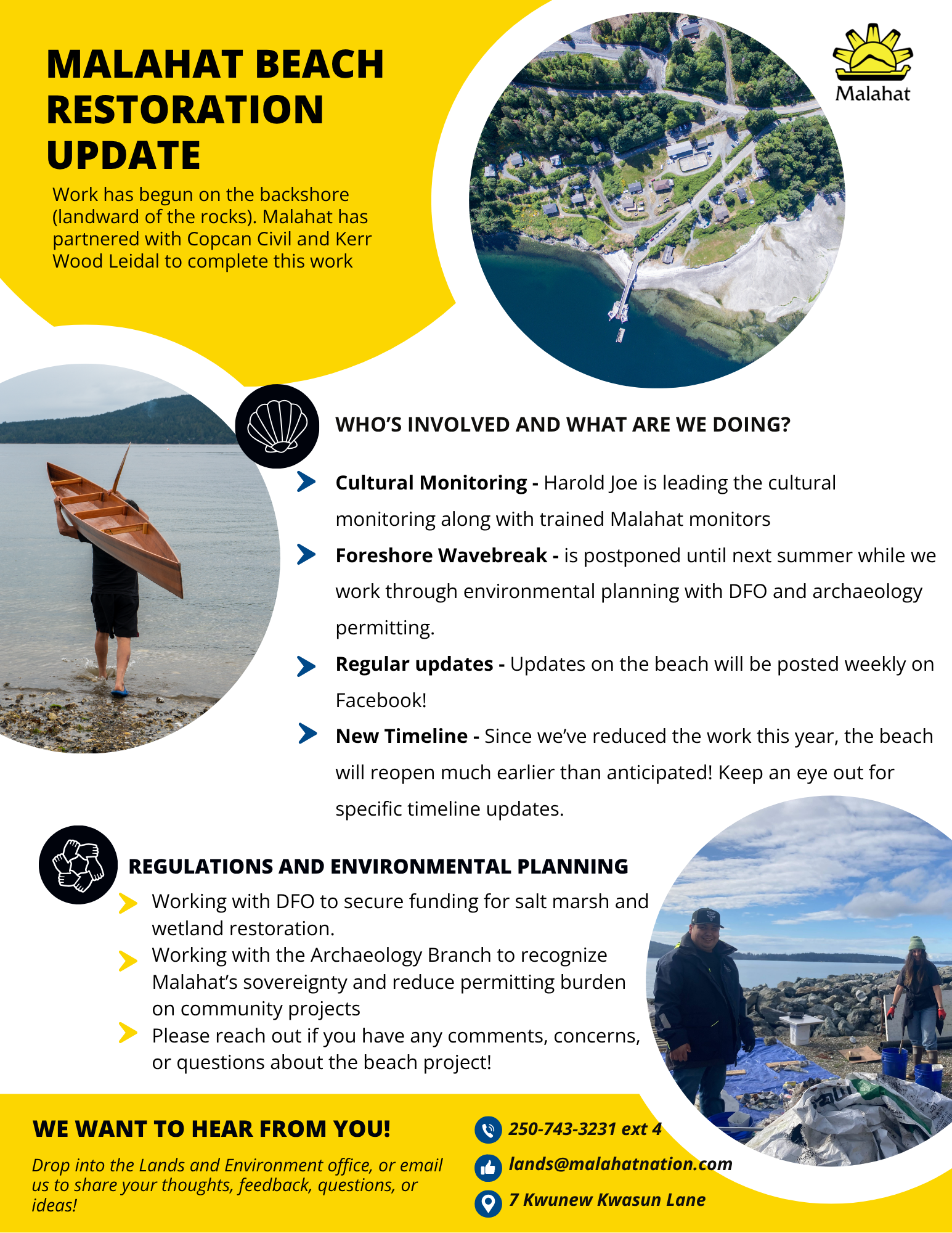

  • Phase II: Construction on the Backshore

    Completed

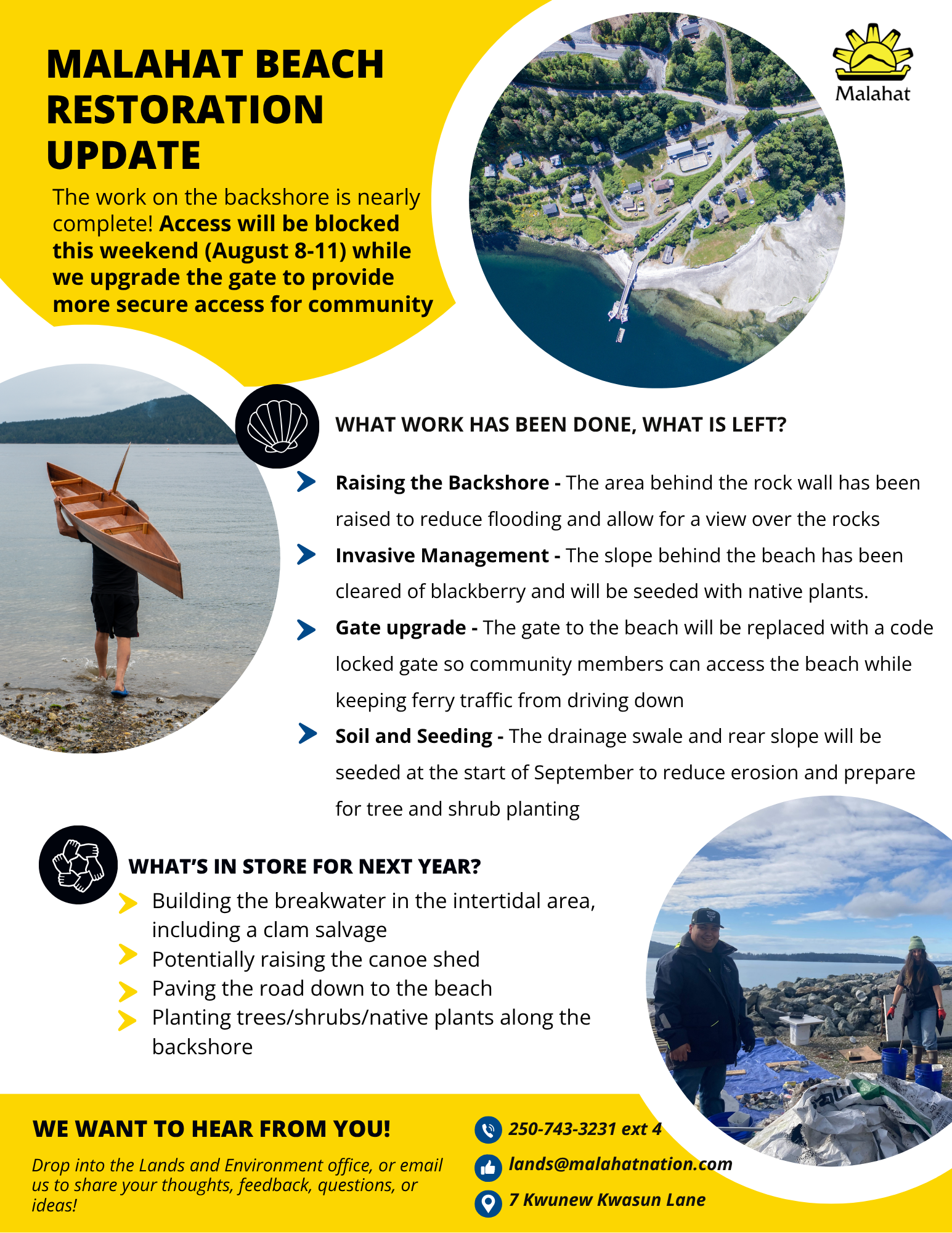

    Jul 2025 - Sep 2025

    Malahat has partnered with Copcan Civil LP to conduct the work on the backshore, the foreshore work has been delayed until next summer.

  • Pahse II: Foreshore Construction

    Approved

    Jul 2026 - Ongoing

    Malahat Lands & Environment will remobilize with Copcan Civil to complete the foreshore work in 2026.

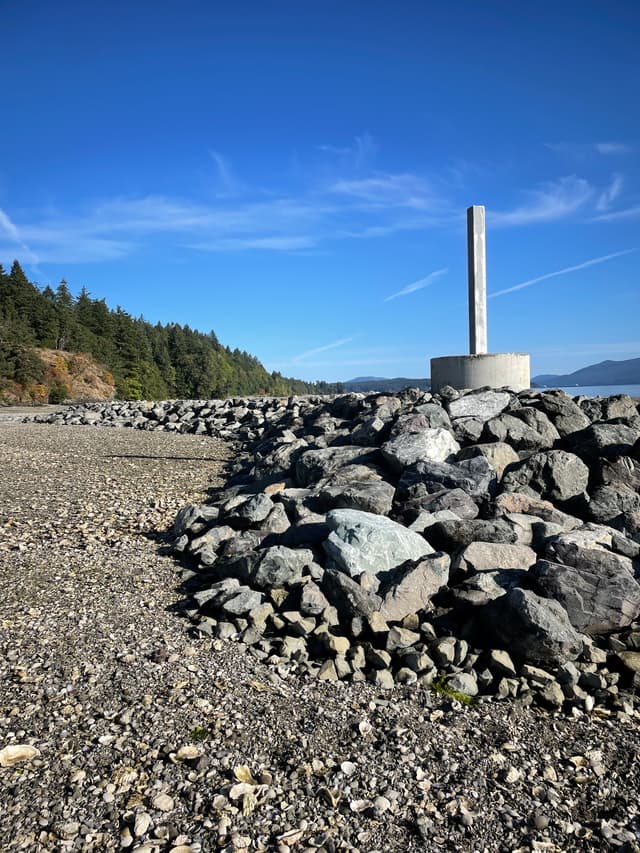

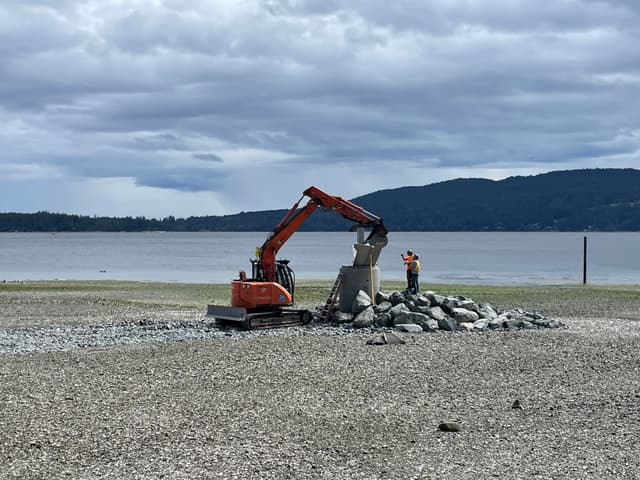

    A riprap (rock) breakwater will be installed in the foreshore, along with a concrete totem carved by John Marston.

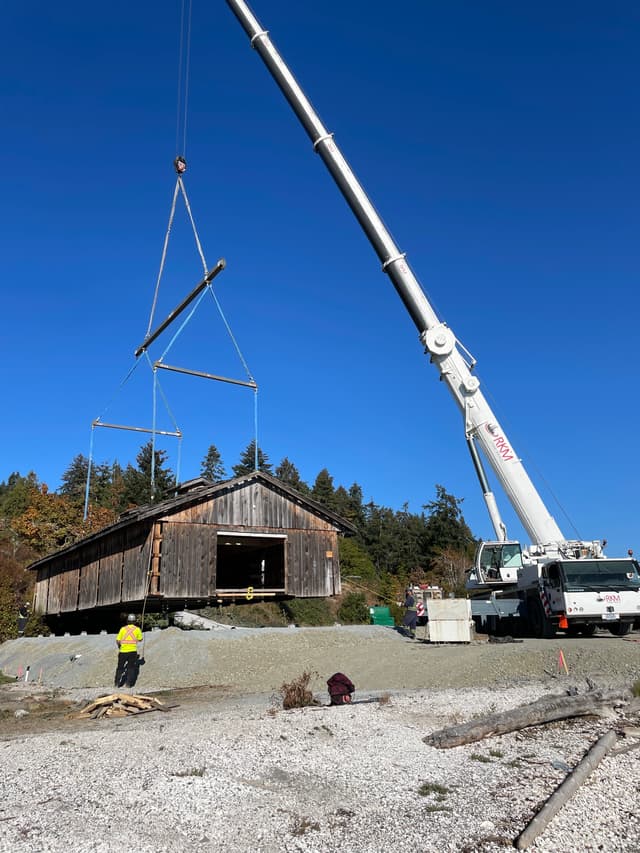

    The Canoe Shed will be raised to reduce flooding risk during storm events and high tides.

Photo Gallery

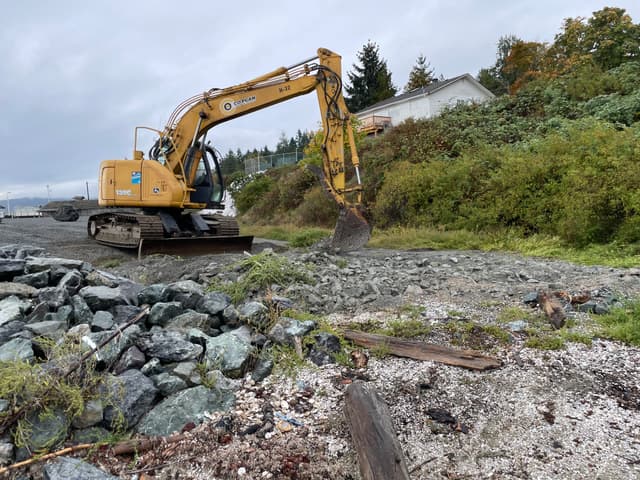

Raising the backshore

Raising the backshore

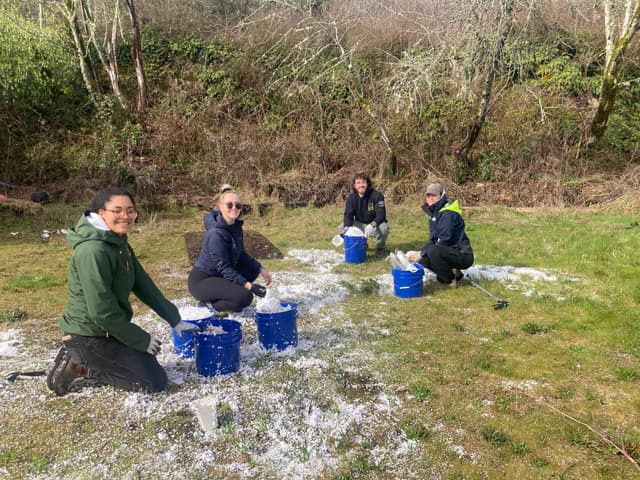

Beach Cleanup - Foam Pellets

Beach Cleanup - Foam Pellets

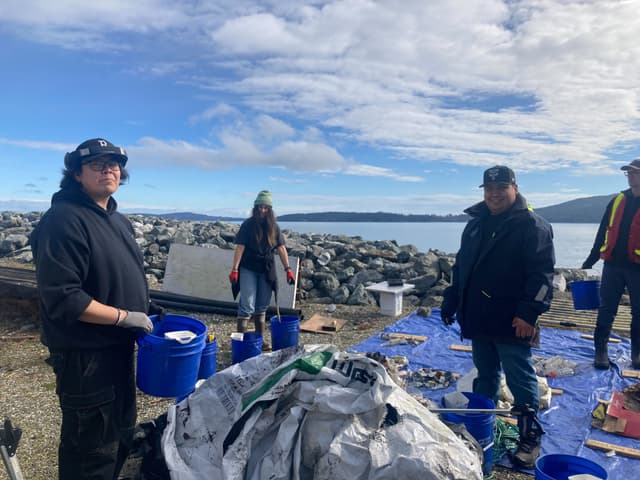

Beach Cleanup
